The forty-day campaign against Iran ended on 8 April 2026 with a fragile ceasefire — and left behind a munitions stockpile deficit that the United States and its allies have no credible near-term plan to close. Pentagon officials confirmed on 29 April that Operation Epic Fury had cost $25 billion, the overwhelming majority in munitions expended. Four weeks on from the ceasefire, the scale of what was fired is clear. What is not clear is how, or when, any of it gets replaced.
For Weapons, Ordnance, Munitions, and Explosives (WOME) professionals and NATO acquisition authorities, the ceasefire does not resolve the industrial base crisis the war exposed. It merely stops the crisis from deepening. Precision munitions stockpiles, as assessed by the Centre for Strategic and International Studies (CSIS) on 21–24 April 2026, sit at depletion levels that industry cannot correct within any operationally meaningful timeframe. That verdict — confirmed independently by the American Enterprise Institute (AEI), the Centre for a New American Security (CNAS), and Air and Space Forces Magazine — is the planning reality NATO acquisition authorities must now act on.
The Six-Week Stockpile Ledger
CSIS published its post-ceasefire munitions assessment on 21 April, updated 24 April. Its findings are stark. Across seven critical munitions categories, US forces expended quantities that will require between one and four years to rebuild to pre-war inventory levels. For four of those seven categories, the United States may have expended more than half of its pre-war inventory in a single six-week campaign.

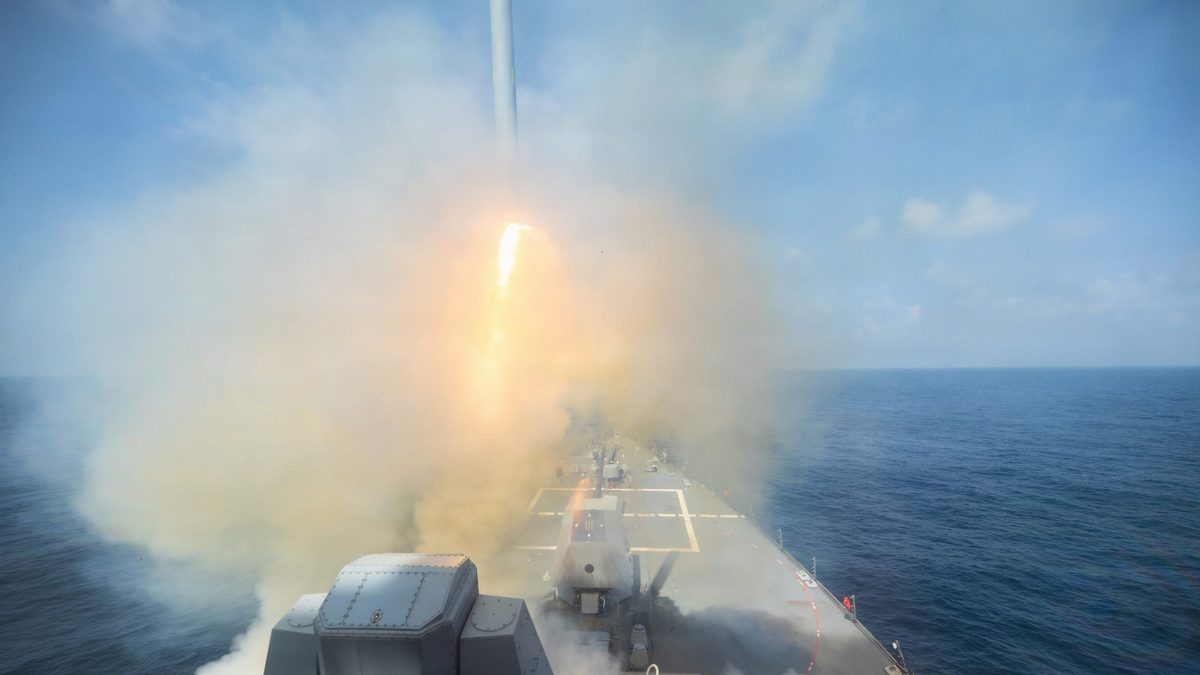

The specific ledger: approximately 1,000 Tomahawk Land Attack Missiles (TLACMs) were fired, against a pre-war estimated inventory of 3,100 — representing roughly 32 per cent of available stock in a campaign lasting fewer than three weeks before the ceasefire. Raytheon Technologies confirmed a Wall Street Journal figure of over 1,000 total Tomahawk expenditures by the time operations paused. The Joint Air-to-Surface Standoff Missile Extended Range (JASSM-ER) toll reached approximately 1,100, against a pre-war inventory of around 4,400 — with B-52s operating from Royal Air Force bases continuing strike sorties until the ceasefire. Over 1,000 Patriot Advanced Capability-3 (PAC-3) Missile Segment Enhancement (MSE) interceptors were expended against Iranian ballistic missiles and one-way attack drones, alongside hundreds of Terminal High Altitude Area Defence (THAAD) and Standard Missile-3 (SM-3) interceptors.
The Precision Strike Missile (PrSM) situation is the most acute of all. An Army official stated that the “entire inventory of PrSM” had been expended during the campaign, though other officials dispute whether a small reserve remains. PrSM, as a recently fielded system with deliveries commencing only in 2023, carried a shallow pre-war inventory. That inventory was consumed. No PrSM deliveries are scheduled that would meaningfully restore it in the near term.
The coalition intercepted more than 1,700 Iranian ballistic missiles and one-way attack drones across 40 days. The interceptor magazine drew down at a rate with no post-Cold War precedent.
“The risk is in a future conflict, like with China, there is now a window of vulnerability, and it’s going to be years before we fully close that.”
— Mark Cancian, Senior Adviser, Centre for Strategic and International Studies, April 2026Allied Stockpile Cascade: From Tennessee to Tokyo
The depletion does not end at US borders. Estonia’s Defence Minister Hanno Pevkur confirmed on 20 April that the United States had paused weapons deliveries to his country, an issue he raised directly with Secretary of Defense Pete Hegseth. Japan, which has contracted for 400 Tomahawk missiles to equip its destroyer force as the cornerstone of a new long-range strike capability, has been told those deliveries may be delayed — a direct consequence of US fleet replenishment drawing from the same depleted production pipeline. Switzerland, facing comparable disruption to its Patriot interceptor order, has reportedly threatened to procure an alternative air defence system. Eighteen nations operate the Patriot, and all are competing for production capacity that was already constrained before the Iran War began.
The allied cascade is particularly significant for Indo-Pacific deterrence. Japan’s Tomahawk capability was intended to provide a credible long-range strike option that complements US forward posture against a potential China contingency. Those missiles are now delayed. The strategic logic of the delivery schedule has not changed; the industrial reality has.
The HSAAP Chokepoint: The Analysis the Analysts Are Not Doing
WJHL Tri-Cities News reported on 12 March 2026 — two weeks into the conflict — that HSAAP had received no order to increase production. As of 5 May 2026, no open-source reporting available to ISC Defence Intelligence confirms that this situation has changed. Every production surge announcement from the Trump administration’s February 2026 framework agreements describes a downstream platform-level acceleration — more Tomahawks per year, more PAC-3 MSE rounds per year — that still depends entirely on an upstream RDX/HMX supply chain whose production rate has not been publicly ordered to expand.

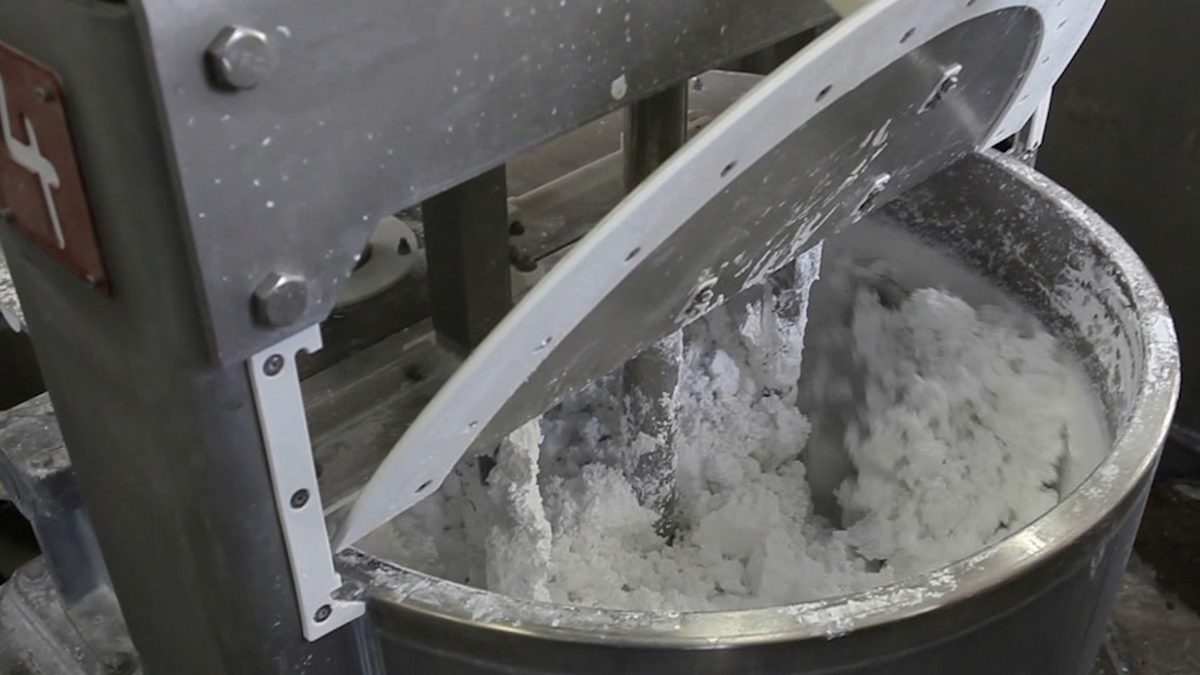

The mechanism that makes this a structural problem rather than a bureaucratic oversight is the GOCO (government-owned, contractor-operated) contractual model under which BAE Systems operates HSAAP. The plant does not expand capacity on operational tempo signals; it expands on multi-year contractual commitments that justify the capital investment required. A 40-day campaign that consumed what several years of production had accumulated cannot be answered at the explosive fill level by a production decision that, as of publication, has not been publicly announced. AOP-7 (Edition 3) governs technical safety standards for energetic materials manufacture, and the AASTP series addresses storage and transport — but no current NATO framework addresses the production-level vulnerability of routing the entire allied precision-strike explosive fill through a 1942-vintage single-source facility.
For AQAP-2110 (Edition D) practitioners and AC/327 quality assurance authorities: the qualification timelines for new RDX/HMX production sources — should any be contracted — will add further months to an already extended supply chain recovery. STANAG 4107 (Edition 11) quality assurance frameworks govern supplier qualification, but they were designed for peacetime production volumes. The gap between their governance model and the production realities now unfolding in Tennessee warrants formal attention from AC/327’s Working Group 2.
Production Surge Announcements: Correct Direction, Wrong Timescale
The Trump administration’s framework agreements with Raytheon Technologies (RTX) and Lockheed Martin, announced in February 2026, are the structurally appropriate response and are overdue. RTX has committed to increasing Tomahawk annual production to more than 1,000 missiles; Standard Missile-6 (SM-6) output is targeted at over 500 per year. Lockheed Martin has announced PAC-3 MSE production of 2,000 missiles per year by 2030 — up from the current 600 — alongside a THAAD interceptor capacity increase from 96 to 400 annually and further PrSM production increases. The FY 2027 Pentagon budget request seeks over $70 billion for missiles and bombs, including $52.9 billion for the twelve most “critical munitions.”
None of this helps in the near term. CSIS documents the standard lead time for a precision munitions order at 36 months before production begins, plus 12 months for the full production lot to be delivered — approximately 52 months in all. Acting Pentagon comptroller Jay Hurst acknowledged on 29 April that the FY 2027 budget “was formulated, honestly, before we went into conflict with Iran.” A Pentagon supplemental of up to $200 billion has reportedly been presented to the White House; no formal request has yet reached Congress.
The arithmetic is unforgiving. Tomahawk and JASSM-ER, at roughly four years of production each consumed in six weeks, cannot be rebuilt by production announcements. Rebuilding to pre-war inventory levels for the seven critical munitions categories will take, in CSIS’s assessment, between one and four years — and that projection assumes the production line acceleration actually materialises on the announced schedules. Production lines that currently yield 600 PAC-3 MSE rounds per year cannot reach 2,000 per year by 2030 without supply chain investments that have not yet been contracted, at facilities that have not yet been qualified under the relevant AQAP standards.
The China Window
General Alexus Grynkewich, NATO Supreme Allied Commander Europe and Commander US European Command, offered the European perspective on 23 April: “For the first time in a long time, money is not the problem in Europe. The real challenge is the production capacity and the defence industrial base, and will capabilities be able to show up on time?” Admiral Samuel Paparo, Commander US Indo-Pacific Command, was more direct about the strategic consequence: “The traditional defence primes have to innovate to go faster. I think it will take one to two years for them to scale. It won’t be soon enough.”
The phrase “won’t be soon enough” is INDOPACOM’s operational verdict on what the Iran War has cost. The window of vulnerability Cancian identifies is not hypothetical. Precision munitions stockpiles that underpin deterrence against a potential China contingency have been drawn down. Japan’s Tomahawk deliveries are delayed. THAAD interceptors — with no new deliveries since August 2023 and resumption not expected before April 2027 — are the most critically depleted single category, with no near-term substitute. China’s strategic planners will have access to the same open-source stockpile analyses that CSIS and AEI have published. That is the intelligence implication of a campaign whose munitions ledger was reported in near real-time.
The rare earth supply chain dimension of the original March assessment has not resolved. China retains approximately 98 per cent of global gallium production, 90 per cent of neodymium processing, and 99 per cent of dysprosium output — elements integral to seeker heads, guidance systems, and radar modules in virtually every precision munition expended in Operation Epic Fury. US DoD Defence Production Act Title III investments in domestic rare earth processing remain years from meaningful volume.
Impact Assessment — Post-Ceasefire
| Domain | Impact Level | Timeframe | Key Consideration |
|---|---|---|---|
| Precision Strike Inventory | CRITICAL | Now–48 months | ~1,000 TLACMs and ~1,100 JASSM-ERs expended; PrSM effectively exhausted; 52-month order-to-field lead time |
| RDX/HMX Production (HSAAP) | CRITICAL | Now | No confirmed production increase order as of 5 May 2026; sole US source; all platform-level surges depend on this upstream choke |
| THAAD Interceptors | HIGH | Now–April 2027 | No new deliveries since August 2023; resumption April 2027 earliest; no near-term substitute; hundreds expended in Epic Fury |
| NATO Allied Stockpiles | HIGH | Now–36 months | Estonia deliveries paused; Japan Tomahawk delayed; Switzerland considering alternative; 18 Patriot nations competing for capacity |
| Indo-Pacific Deterrence | HIGH | Now–48 months | China window of vulnerability confirmed by INDOPACOM; Japan Tomahawks delayed; China can read same open-source assessments |
| Rare Earth Supply Chain | HIGH | Medium-term | China retains 98% gallium share; DoD Title III domestic processing years from volume; no near-term substitution path |
| 155mm Artillery | MODERATE | Now–18 months | US ramp to 100,000 rounds/month by mid-2026 on track; unguided conventional munitions less constrained than guided systems |
What NATO Acquisition Authorities Must Do Now
The immediate action for Allied acquisition authorities is a tri-level stockpile audit. First: identify every precision-guided munition in national inventories and map current holdings against the burn rates the Iran War has demonstrated for a high-intensity, precision-strike-heavy campaign. Any stockpile that could reach zero within 30 days of a peer-competitor engagement is a planning liability. Second: identify which systems share the RDX/HMX fill dependency and the HSAAP bottleneck — and determine whether any contractual or industrial basis exists for accelerating European-sourced production of equivalent explosive fill compounds under allied industrial programmes. Third: raise the HSAAP upstream question directly with US counterparts. Whether a production increase has been contracted is a binary question with a significant operational consequence. The answer should not remain absent from allied planning documents.
For quality assurance professionals operating under AQAP-2110 (Edition D) or national equivalents: any emergency sourcing of RDX or HMX from non-HSAAP suppliers will require a supplier qualification process under STANAG 4107 frameworks before that material can legally enter the NATO munitions supply chain. Those qualification timelines are measured in months to years. If qualification processes have not started, they are already late.
