$157M to Upgrade the Osprey: Investment in Capability or Life Support for a Troubled Platform?

Bell Boeing’s latest V-22 upgrade contract is presented as a step toward restoring tiltrotor readiness — but with 65 fatalities, 28 unresolved catastrophic safety risks, and full gearbox fixes not due until 2034, the harder question is whether $157 million buys genuine capability improvement or merely extends the operational life of an aircraft the US Marine Corps is already exploring replacements for.

A US Air Force CV-22 Osprey tiltrotor aircraft in flight over the New Mexico plains during a training exercise
A CV-22 Osprey assigned to the 20th Special Operations Squadron conducts a training exercise over New Mexico, 9 October 2024. The CV-22B variant serves USAF Special Operations Command and is one of three variants covered by the new $157M upgrade contract. US Air Force / A1C Gracelyn Hess via DVIDS. Public domain.

The Contract: What We Know

Bell Boeing has been awarded an indefinite-delivery/indefinite-quantity (IDIQ) contract valued at up to $157 million for upgrades to the V-22 Osprey tiltrotor aircraft fleet. The contract covers engineering, modification, and integration work across the three V-22 variants operated by the United States military: the MV-22B (US Marine Corps), the CV-22B (US Air Force Special Operations Command), and the CMV-22B (US Navy carrier onboard delivery). Work is expected to be performed primarily at the Bell Boeing Joint Project Office in Amarillo, Texas, with additional work at Bell’s facility in Fort Worth, Texas and Boeing’s rotorcraft division in Ridley Park, Pennsylvania.

The contract is administered by the Naval Air Systems Command (NAVAIR), Patuxent River, Maryland, the programme executive office responsible for all three V-22 variants through the V-22 Joint Program Office (JPO). As an IDIQ vehicle, the $157 million figure represents a ceiling — individual task orders will be issued against this ceiling as specific upgrade requirements are defined and funded. The contract structure gives the government flexibility to prioritise work packages based on operational need and available appropriations.

Contract Element Detail
Contractor Bell Boeing Joint Project Office (Bell Textron / Boeing)
Contract Type Indefinite-Delivery/Indefinite-Quantity (IDIQ)
Maximum Value $157,000,000
Contracting Agency Naval Air Systems Command (NAVAIR), Patuxent River, MD
Variants Covered MV-22B (USMC), CV-22B (AFSOC), CMV-22B (USN)
Primary Work Location Amarillo, TX (Bell Boeing JPO)
Additional Locations Fort Worth, TX (Bell); Ridley Park, PA (Boeing)
Scope Engineering, modification kits, integration, and testing for platform upgrades
A CMV-22B Osprey launches from the flight deck of USS Carl Vinson in the Pacific Ocean
A CMV-22B Osprey from Fleet Logistics Multi-Mission Squadron 30 (VRM-30) launches from USS Carl Vinson (CVN 70) in the US 3rd Fleet area of operations, 15 June 2024. The Navy’s CMV-22B variant provides carrier onboard delivery capability and is among the platforms covered by the new upgrade contract. US Navy / MC2 Derek Kelley via DVIDS. Public domain.

This contract sits within a broader pattern of V-22 sustainment and upgrade spending. In the past 24 months alone, the V-22 programme has generated multiple significant contract actions: a $590 million modification for five new CMV-22B aircraft (completion January 2028), a $149 million DLA-exercised option for engineering and logistics services, and a $19.3 million contract for software upgrades across all three service variants. The cumulative investment signals a commitment to sustaining the V-22 through at least the early 2030s. Whether that commitment is warranted depends on whom you ask.

The Safety Record: 65 Dead and Counting

Any assessment of V-22 upgrade investment must contend with the platform’s catastrophic safety record. As of July 2025, 65 service members have been killed in V-22 mishaps across the programme’s operational history. Since 2022 alone, four fatal crashes have killed 20 and injured another 20. The tempo of catastrophic incidents is not declining.

The mechanical root causes are well-documented. The most deadly single incident — the crash of a CV-22B Osprey off Yakushima, Japan, on 29 November 2023 that killed all eight crew — was caused by catastrophic failure of the left-hand proprotor gearbox (PRGB). The investigation, published in August 2024, attributed the failure to cracking in a high-speed pinion gear caused by an inclusion — a manufacturing flaw in the X-53 steel alloy that created a stress concentration point in the gear material. This is a metallurgical defect, not a maintenance failure.

In November 2024, a second CV-22B experienced failure of a critical gear due to an identical inclusion defect. That aircraft landed safely, but the incident prompted a partial fleet grounding and the introduction of new operational restrictions: all V-22s were limited to flying within 30 minutes of a landing zone. Those restrictions remained in force through 2025, and the Navy and Air Force fleets may not return to unrestricted operations until mid-2026 at the earliest.

The second major mechanical failure mode is hard clutch engagement (HCE) — a phenomenon in which the clutch assembly connecting the engine to the proprotor gearbox engages abruptly rather than smoothly, causing a sudden and potentially unrecoverable transfer of torque. HCE was the proximate cause of the June 2022 fatal crash of a US Marine Corps MV-22B in California that killed five Marines. The HCE problem had been identified years earlier but was not resolved before the fatal incident occurred.

“The V-22 has the oldest age of unresolved catastrophic system safety risk assessments across the Navy’s aircraft inventory, with an average of more than 10 years.” — GAO / NAVAIR Safety Review, December 2025

28 Unresolved Catastrophic Risks: The GAO and NAVAIR Findings

In December 2025, both the Government Accountability Office (GAO) and NAVAIR published reviews that laid bare the scale of unresolved safety risk in the V-22 programme. The findings were damning.

The V-22 carries 28 unresolved catastrophic system safety risk assessments — the highest total among all Navy rotary-wing aircraft and second only to the F-35 across the entire Navy aircraft inventory. Seventeen of those 28 risks have remained unresolved for 6 to 14 years. The median age of unresolved serious and medium risks is approximately nine years. Five of the twelve Class A mishaps in the preceding four years resulted in catastrophic outcomes from previously identified mechanical risks — meaning the programme knew about the failure modes and had not resolved them before they killed people.

The GAO specifically warned that “without refining the joint program’s process for identifying, analysing, and responding to Osprey safety risks… programme stakeholders cannot adequately mitigate risks.” The review noted that prior safety investigations in 2001, 2009, and 2017 “lacked mechanisms for tracking implementation or accountability” — a systemic pattern of identifying problems, recommending fixes, and then failing to verify those fixes were actually implemented.

The timeline for resolving the most critical failure mode — the PRGB inclusion defect — stretches into the next decade. The V-22 JPO originally planned to begin fielding triple-melt gears (manufactured from steel processed through three melting stages to eliminate inclusions) in summer 2025. That date slipped to January 2026. Full implementation of the upgraded gearbox across the entire fleet is not expected until 2034. Until then, every V-22 flying with original-specification gears carries a known risk of catastrophic gearbox failure.

US Marines conduct maintenance on an MV-22 Osprey at MCAS New River prior to return to flight operations
Marines with VMM-365 (REIN) conduct maintenance on an MV-22 Osprey at MCAS New River, North Carolina, 12 March 2024, as part of a “deliberate and methodical approach to returning their MV-22s to full operational capacity” following the fleet-wide grounding. With mission-capable rates averaging 50–60%, maintenance burden remains a central challenge for the programme. USMC / LCpl Ryan Ramsammy via DVIDS. Public domain.

Readiness: Half the Fleet Unavailable, Half the Time

The safety issues compound a readiness problem that predates the recent crash investigations. Between 2020 and 2024, the V-22’s average mission-capable rate was approximately 50% for the Navy and Air Force variants and 60% for the Marine Corps MV-22B. These figures mean that on any given day, roughly half the fleet is unavailable for tasking.

For context, a 50% mission-capable rate requires the services to maintain and fund nearly twice as many airframes as they actually need for operations — a planning factor that drives up total ownership cost substantially. The V-22’s operating and maintenance costs per flight hour have increased by 30% over the past four years. For the Navy’s CMV-22B carrier onboard delivery variant, low readiness has particular operational consequences: each aircraft occupies scarce deck space on nuclear-powered aircraft carriers, and an aircraft that cannot fly still consumes maintenance hours, spare parts, and hangar capacity.

The serious mishap rate for V-22s has exceeded both Navy and Air Force fixed-wing and rotary-wing averages between 2015 and 2024. Put bluntly, the Osprey crashes more often, is available less often, and costs more to sustain per flight hour than comparable platforms. The $157 million upgrade contract must be evaluated against this operational reality.

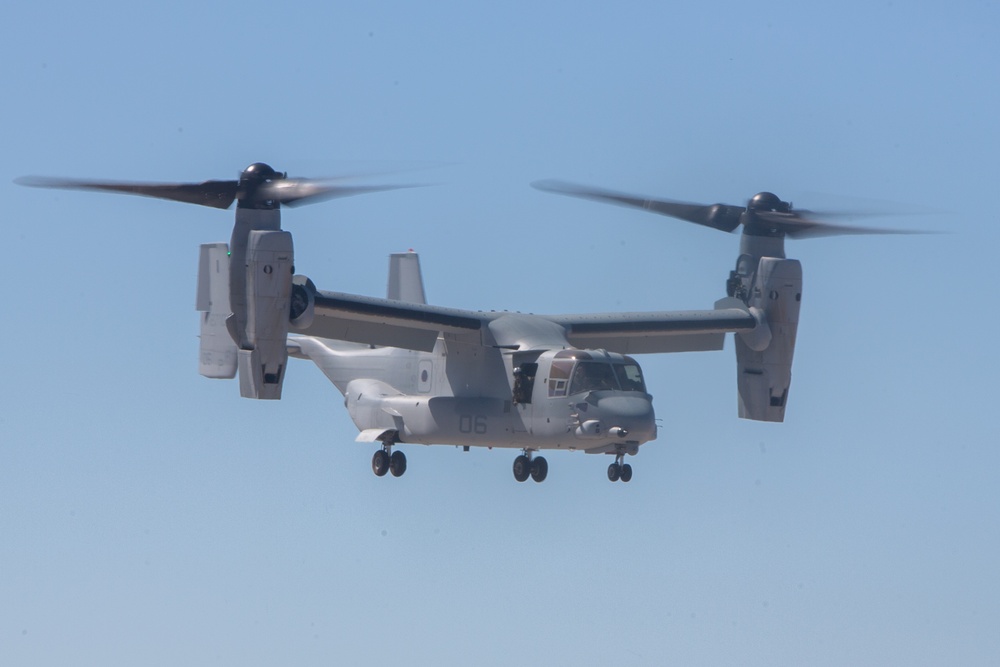

A US Marine Corps MV-22B Osprey tiltrotor aircraft performs a flight demonstration with rotors in transition at the 2024 Miramar Airshow
An MV-22B Osprey from 3rd Marine Aircraft Wing performs a flight demonstration at MCAS Miramar Airshow, San Diego, 28 September 2024. The Marines are already exploring what comes after the Osprey through the Next Generation Assault Support (NGAS) programme, while Bell transitions its tiltrotor line toward the V-280 Valor FLRAA. USMC / Cpl Arthur W. Shores via DVIDS. Public domain.

The Replacement Conversation Nobody Wants to Have

While the Department of Defense continues to invest in V-22 upgrades, the US Marine Corps has quietly begun exploring what comes after the Osprey. The Next Generation Assault Support (NGAS) programme is the USMC’s initiative to identify a future vertical lift platform that could eventually replace the MV-22B. No formal requirement has been published, and the programme remains in the early conceptual phase, but its existence acknowledges that the V-22 is not a permanent solution.

Simultaneously, Bell is transitioning its tiltrotor production line from the legacy Osprey toward the Future Long-Range Assault Aircraft (FLRAA) — the US Army’s next-generation tiltrotor selected in December 2022. Bell’s V-280 Valor won the FLRAA competition, and the company has secured production contracts extending Osprey manufacturing through 2027 specifically to bridge the gap until FLRAA production begins. The industrial subtext is clear: the Osprey production line has a defined end date, and the manufacturer is already building the next platform.

Critics of continued V-22 sustainment investment argue that pouring hundreds of millions into upgrades for an aircraft with known, decade-old unresolved catastrophic risks represents a sunk-cost fallacy. The counter-argument — made by the V-22 JPO and Bell Boeing — is that the tiltrotor provides a unique capability (vertical takeoff with fixed-wing speed and range) that no other in-service platform can replicate, and that the alternative to sustainment is a capability gap that the services cannot afford.

Both arguments have merit. The question is one of resource allocation: does $157 million in upgrade funding generate more operational value than the same investment in accelerating FLRAA development, expanding CH-53K procurement, or addressing the underlying metallurgical and design issues that have killed 65 people?

Inter-Service Coordination: Three Services, Three Standards

The December 2025 NAVAIR review surfaced a problem that compounds both the safety and readiness challenges: the three services operating V-22s maintain different maintenance and operation standards for what is nominally the same aircraft. The report stated that “significant discrepancies and differences in critical aircrew and maintenance publications and procedures exist across the USN, USMC and USAF.”

This is not a minor administrative issue. Different maintenance intervals, different inspection criteria, and different operational procedures across three service branches mean that safety lessons learned by one service may not be implemented by the others. The Yakushima crash killed Air Force special operations personnel; the HCE crash killed Marines. The investigation findings applied to all variants, but the implementation of corrective actions has proceeded at different paces across the three services. Gold Star widow Amber Sax, whose husband was killed in a V-22 crash, stated that the GAO findings confirmed “more needed to be done” and that “failure cost my husband his life.”

ISC Commentary

The $157 million Bell Boeing upgrade contract is neither scandalous nor straightforward. It represents a rational decision within a constrained system: the V-22 provides a capability no other platform currently replicates, the fleet must remain operational until a successor is fielded, and upgrades are cheaper than premature retirement. But the contract also funds modifications to an aircraft with 28 unresolved catastrophic safety risks — 17 of which have festered for over six years — while full gearbox fixes will not reach the entire fleet until 2034.

The uncomfortable truth is that the V-22’s continued operation represents an accepted risk calculus: the Department of Defense has decided that the capability the tiltrotor provides outweighs the known probability of further mechanical failures, and that sustainment investment is preferable to a capability gap. Whether that calculus is correct is a question for Congress and the families of the 65 service members who have died in V-22 mishaps. ISC Defence Intelligence assesses that the key metric to watch is not the contract value, but whether the upgraded gearbox fielding timeline holds or slips further beyond 2034.
